Allandale25
Senior Member
^ There were also some remarks about the sidings at Guelph and Acton. Nothing on the 'hole in the donut' as the late and sometimes spicy TOAreaFan used to say, aka Bramalea-Georgetown.
@Allandale25 posted this clip of the Mx Board Meeting elsewhere:
1) Caledonia Station (Barrie GO) on target to start construction by year's end, with an in-service date of 3-4 years given.
2) Maple GO targeted for full-return of normal operations by Spring' 25
3) For Stouffville GO Line, there will be a major closure in July (this month) to upgrade signals at 5 at-grade crossings.
New track near McNicoll has been commissioned.
There was a rather vague statement about a third and final commissioning phase for tracks works 'in the southern area, close to Scarborough Junction' (his words). That would be 'later this year'.

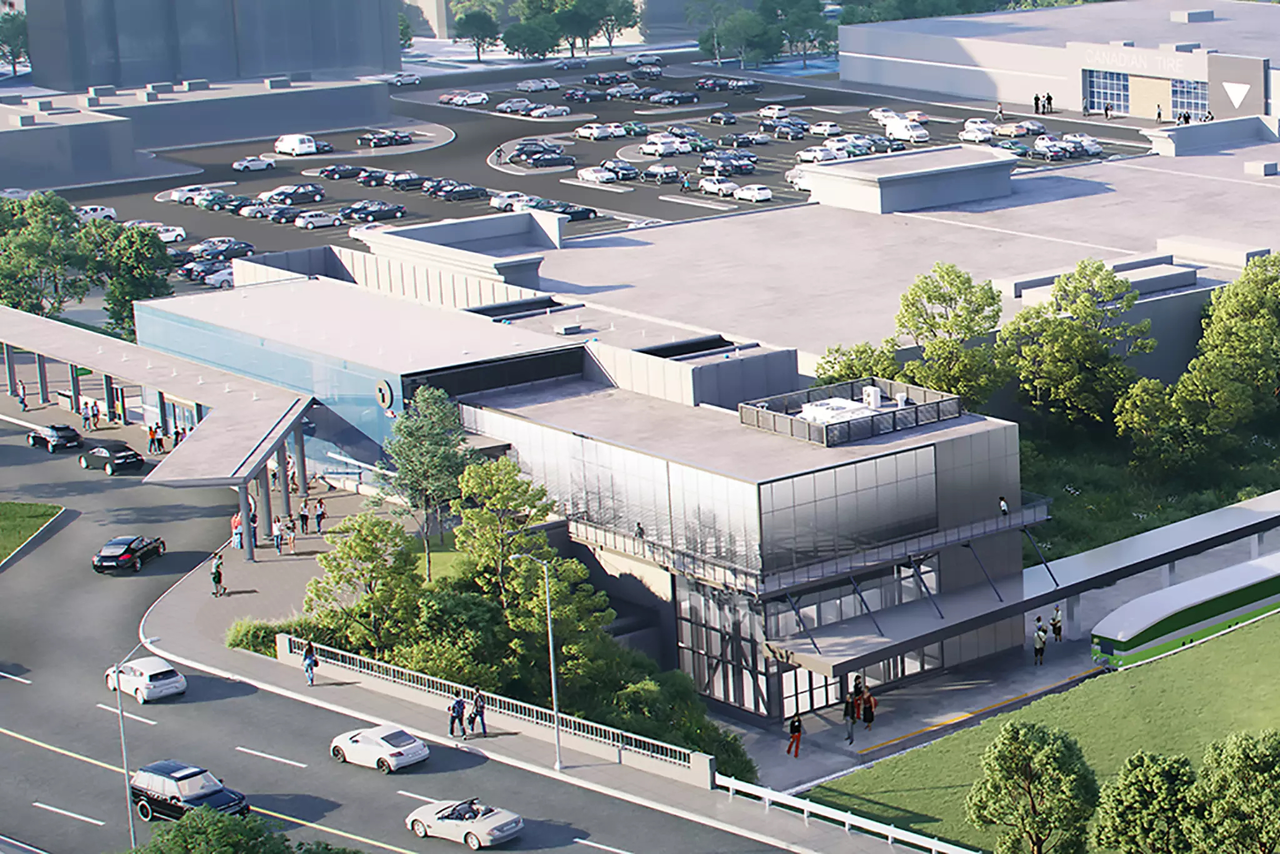

Yup, we've seen these renderings before. And yes, Phase 1 is a single platform. A future Phase 2 will see Platform 2 built, along with the pedestrian bridge over the Barrie Line.Just saw this render of Caledonia Station
View attachment 577266
Please tell me they're not going to build this is a single platform station...
Just saw this render of Caledonia Station
Please tell me they're not going to build this is a single platform station...
The rendering I have seen shows a walkway over the corridor that connects to the street and a east platform.Just saw this render of Caledonia Station
View attachment 577266
Please tell me they're not going to build this is a single platform station...
My question is why? We are already double tracking the Barrie Line with side platforms, and according to the information this will take 4 years to build (so earliest finish late 2028). The explanation by @crs1026 implies that they're thinking of triple tracking the station, which would be somewhat understandable, however the Architectural plans, available as part of the development application available on Toronto's Website (dated December 1st 2023) shows a double track station with no room left for an express track:The video I linked to clearly states that initial configuration will be a single platform on the west side, though they do intend to future proof for something larger.

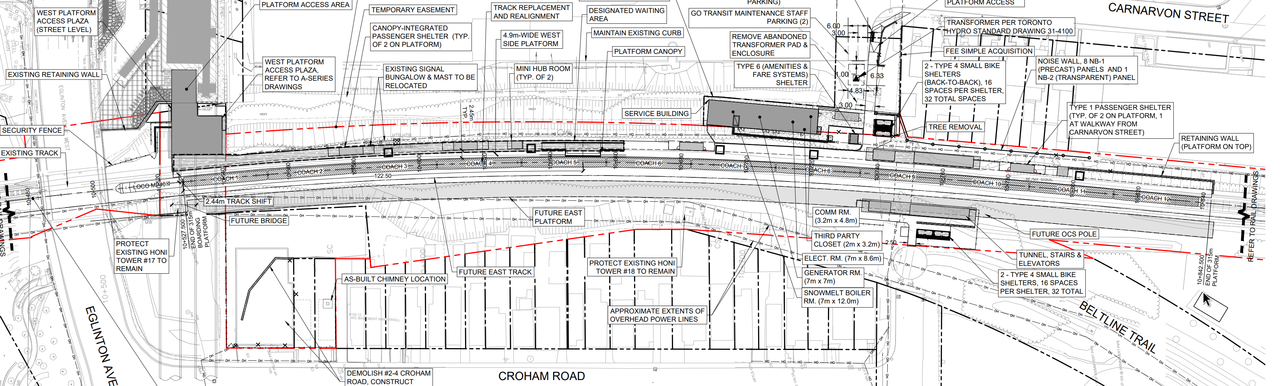

My question is why? We are already double tracking the Barrie Line with side platforms, and according to the information this will take 4 years to build (so earliest finish late 2028). The explanation by @crs1026 implies that they're thinking of triple tracking the station, which would be somewhat understandable, however the Architectural plans, available as part of the development application available on Toronto's Website (dated December 1st 2023) shows a double track station with no room left for an express track:
BTW the EA for the Caledonia GO was initiated in April 2015 and the RFP for design of the station was let in July 2020. And here we are in July 2024, waiting to hear who is selected to build the station. Construction will take 3-4 years. This is not the steady expeditious flow of progress that Mr Verster waxes poetic about in Board meetings.
- Paul
Since when do Metrolinx promises mean anything?Even if a second GO Caledonia platform was built now, how much use of it would occur prior to electrification given Metrolinx’ promise not to increase diesel movements as part of the Davenport overpass process? Of course, the upside would be forgoing construction inflation, and disruption during 2nd platform retrofit. But there are a lot of projects in play and I’m just happy to see some progress on this
Building only a single platform in the first phase made sense way back in the early 2010's when the station was originally designed, but now that construction has been delayed it seems that the station would open around the same time as the double track anyway. Failing to include the second platform in the first phase of the GO station construction could result in a similar situation that we had at Milliken station where a second track was built through the station, and then immediately demolished without ever having served a train to make room for construction of a second platform.It's always risky to take renderings too literally (although sometimes they reveal important details that no one has talked about) - but -
First, I reported what was approved in the TPAP, ie two station tracks and one "express" track. The TPAP is now almost a decade old. There have been various iterations to the plan since then, and so the TPAP is somewhat ancient history - except that, having gotten EA approval, it will be easier to proceed all the way to triple track if that is ever actually needed. But the best answer at the moment is - while parts of the corridor including Caledonia GO could possibly be built out to three tracks some day, and ML's construction includes futureproofing towards that, it's pretty clear that ML is not proceeding to that for the immediate future..
Second - has ML abandoned double track? If so, they aren't saying.... despite having repeatedly declared they are double tracking all the way to Maple at least. The roadbed segment south of Caledonia GO (ie the flyover, and northwards from it to just south of Eglinton) is clearly being prepared for double track, as is the segment from Lawrence up to Steeles. If ML is planning to leave a segment of single track from Eglinton to Lawrence, that's new information, and is a bit at odds with the premise of 2WAD on 15 minute or better headways. I would expect that a 2-platform station would be prudent if not essential for that level of traffic.
Possibly ML has changed its mind, or has decided on a service plan that offers only limited service at Caledonia, or ONExpress has offered a new view. OR possibly the second platform has been deferred for cash flow reasons. Or possibly it's just a disconnect between the designers and the PR people who asked for some fresh renderings..
If ML is now saying single track....I would say this is a classic example of ML changing its mind too frequently and not sticking with a plan.... as well as not being transparent about the scope of its work, and not being accountable for minimising rework and redundant re-planning. I continue to grind the axe about how detailed scope for all ML projects needs to be discoverable, and changes to scope need to be minuted and also discoverable.
BTW the EA for the Caledonia GO was initiated in April 2015 and the RFP for design of the station was let in July 2020. And here we are in July 2024, waiting to hear who is selected to build the station. Construction will take 3-4 years. This is not the steady expeditious flow of progress that Mr Verster waxes poetic about in Board meetings.
- Paul
similar to the situation with the roadworks on 16th ave across from the former buttonville airport. its taken so long to construct that the brand new short stubby street lights designed based on the run way restrictions areBuilding only a single platform in the first phase made sense way back in the early 2010's when the station was originally designed, but now that construction has been delayed it seems that the station would open around the same time as the double track anyway. Failing to include the second platform in the first phase of the GO station construction could result in a similar situation that we had at Milliken station where a second track was built through the station, and then immediately demolished without ever having served a train to make room for construction of a second platform.
