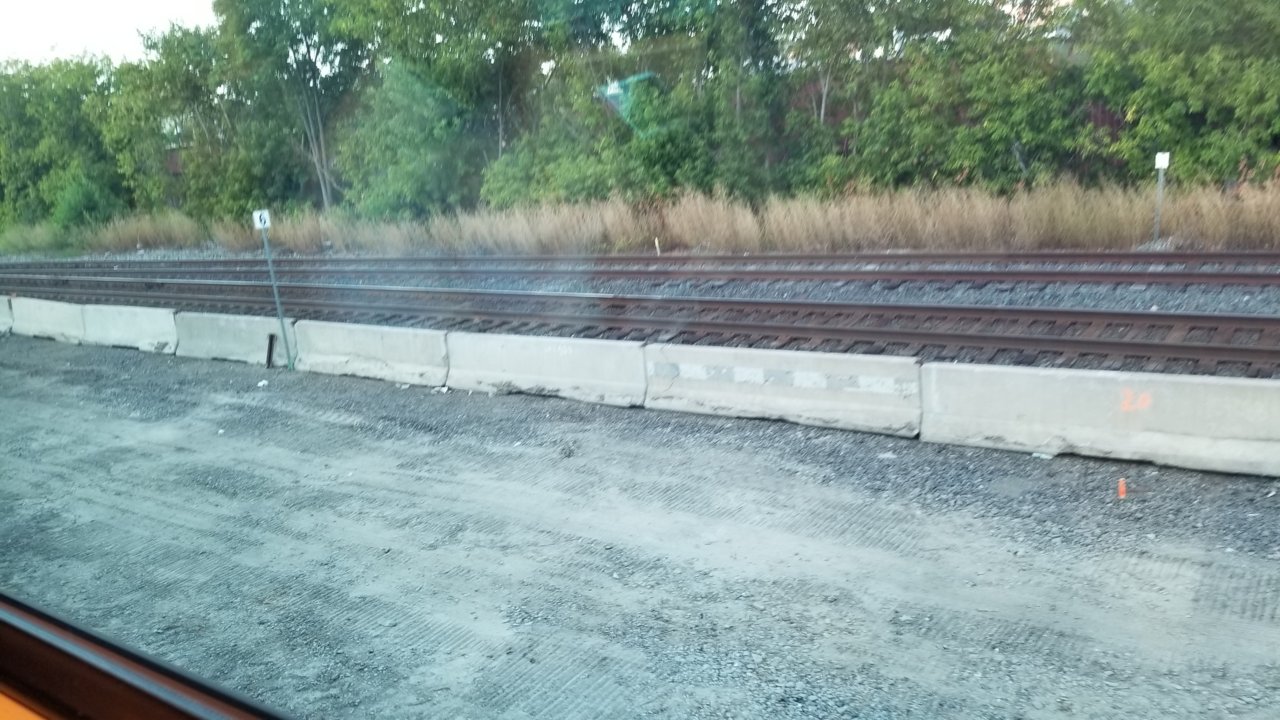

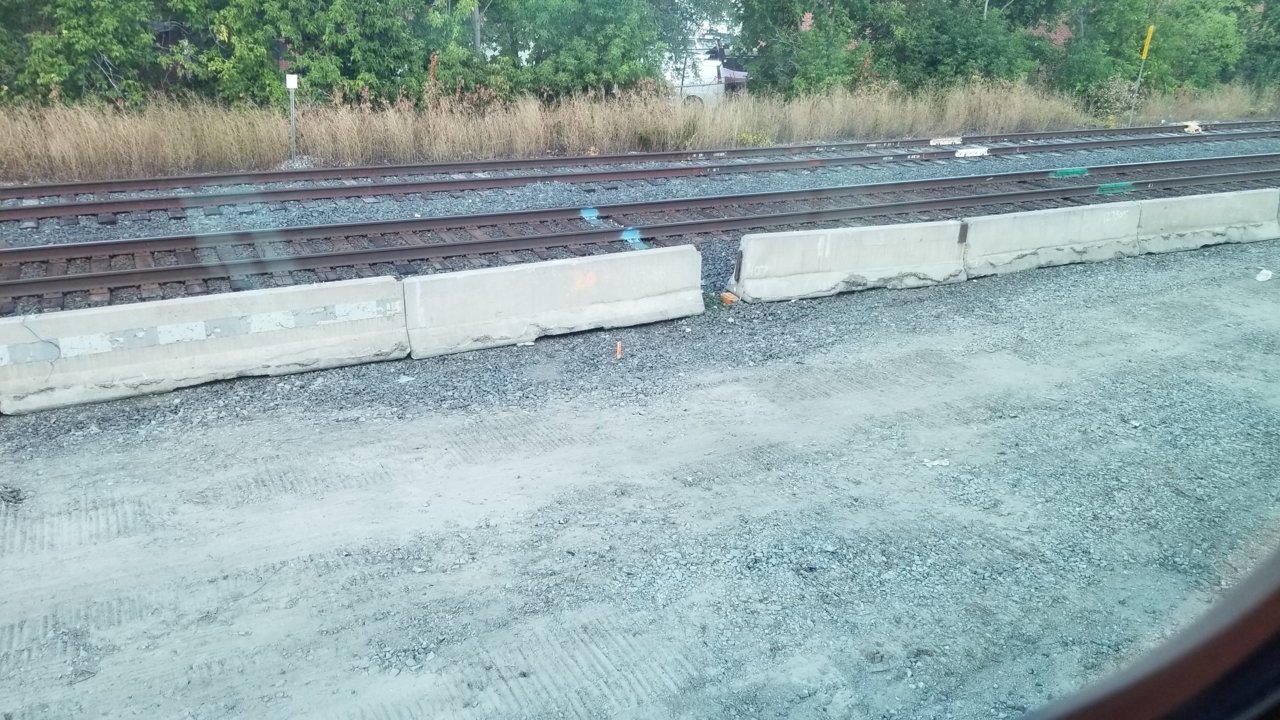

I had business in Markham today, and while coming back I took some video of progress on the Stouffville line.

Most notable is that the hardware for a set of crossovers is staged around Progress Ave. That demarcates the North and Central zones of the project. Supposedly Milliken-Progress is to be put in service first, and Progress-Kennedy second. From my observation, there is a lot more to do north of Progress than south of it.

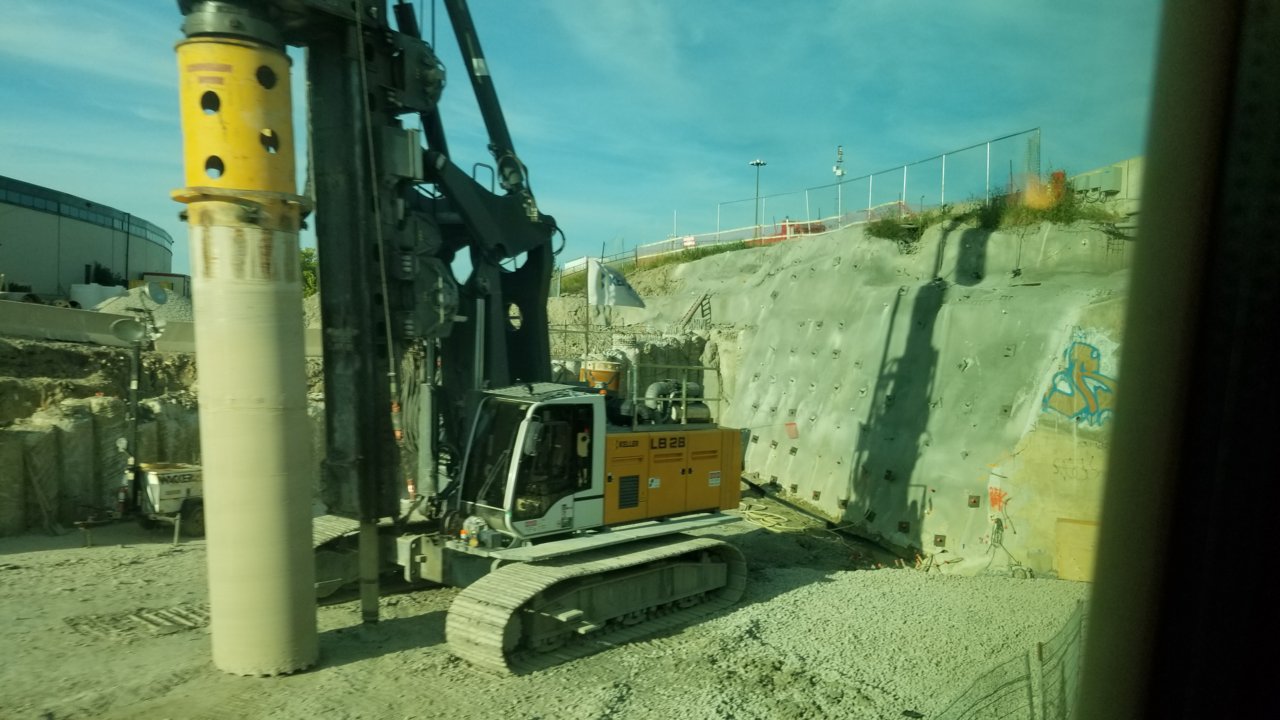

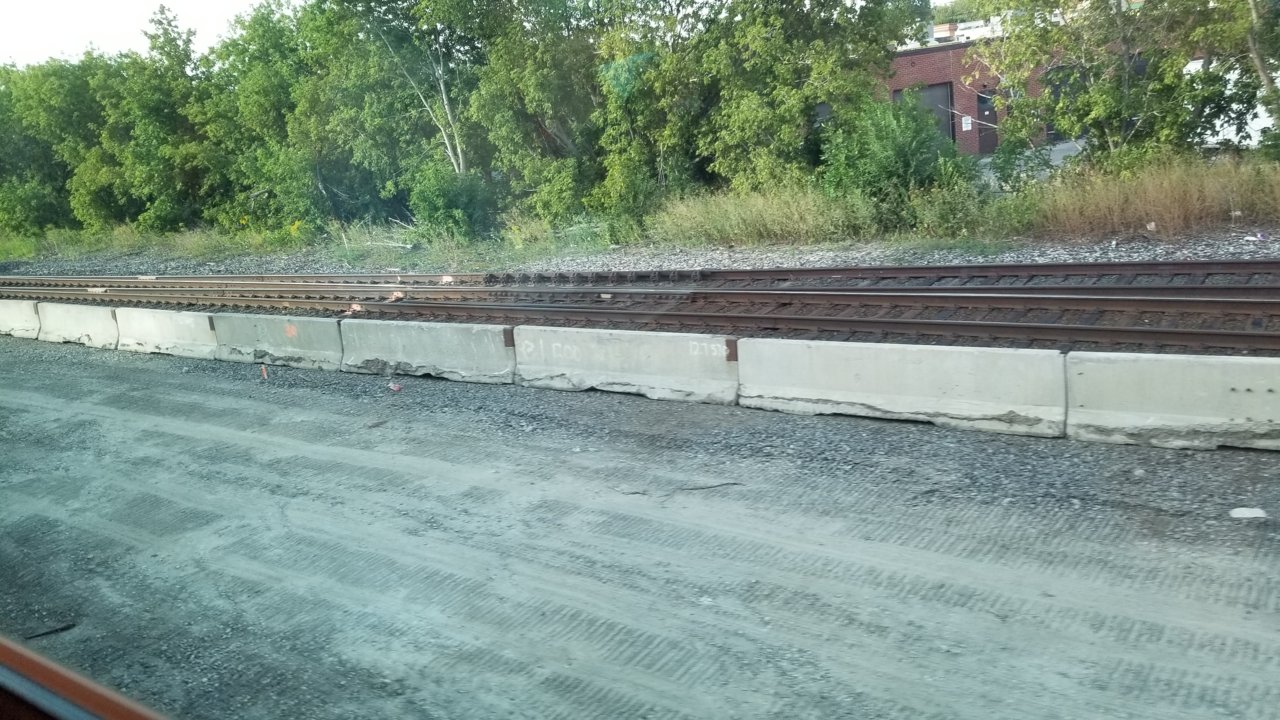

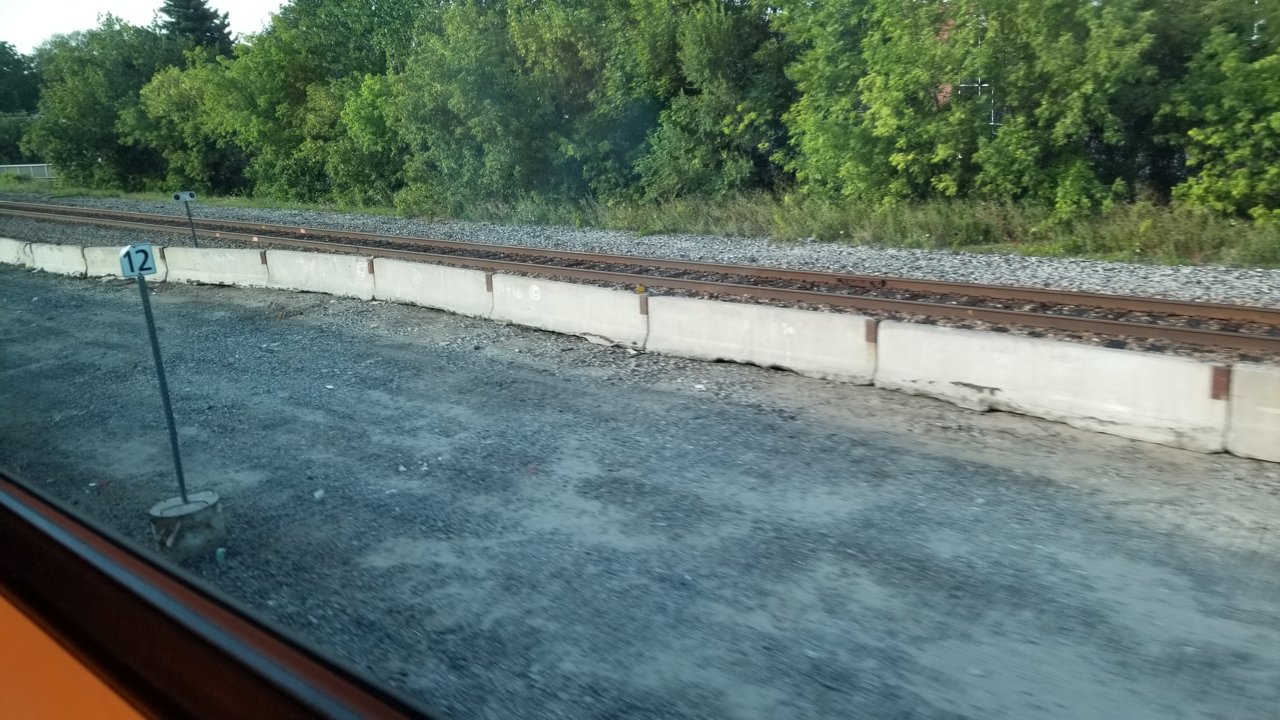

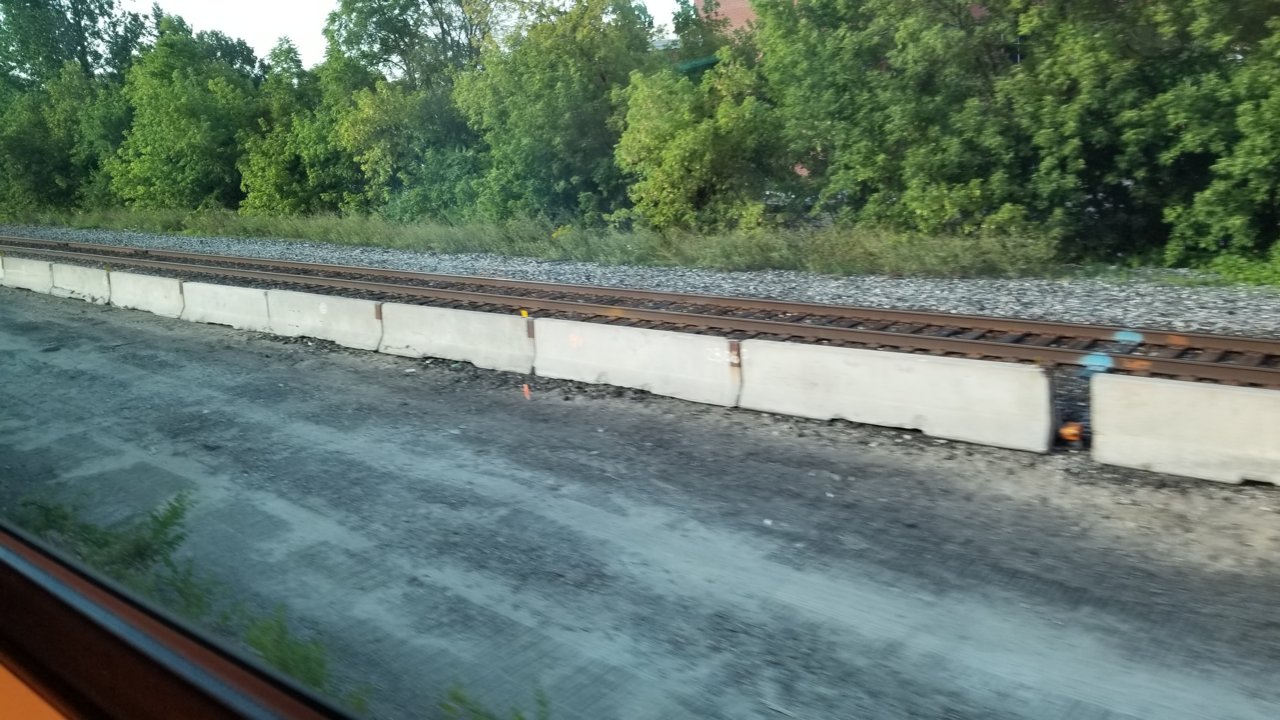

This first video starts at Milliken, heading southward. It shows that apart from some small bits north of McNicoll, the second track bed isn't anywhere near ready for laying track. Lots of water, some excavations still going on, and lots of fiber conduit that remains to be trenched, and much sound fencing to install. Plenty of progress on the tunnels at Agincourt (as there was at Milliken). One has to remember that after the second track is laid, it becomes the single main line while the "old" line is torn out and relaid with vibration matting and then fresh ballast and concrete ties. So really we aren't at the 50% track laid point yet.

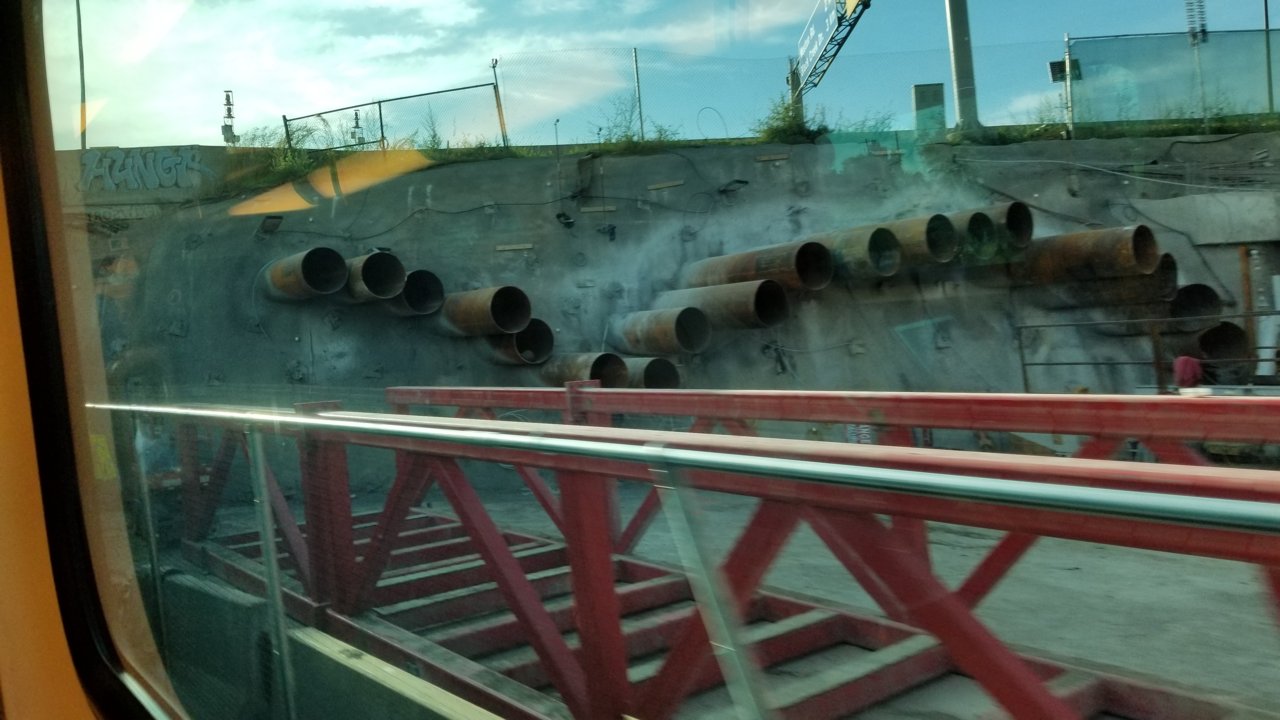

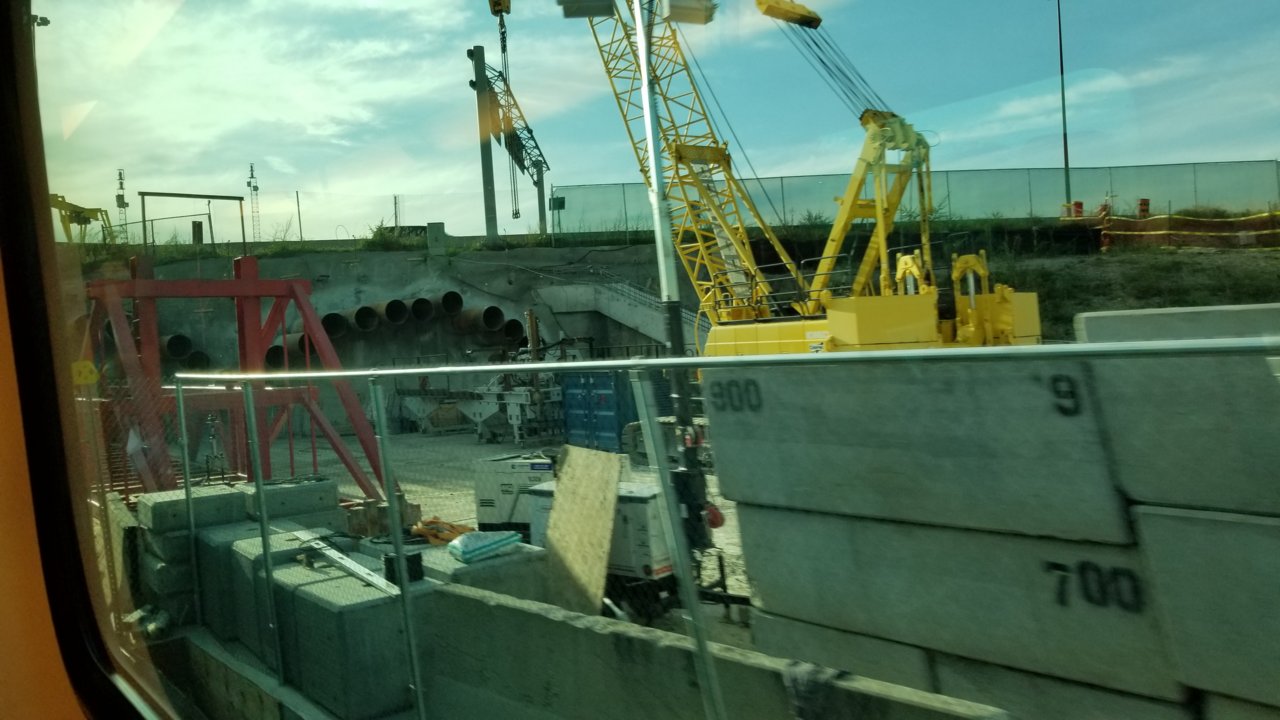

The second video runs from Agincourt southwards. One can see that the bridgework over the creeks is just getting underway. Again, lots of second track needs to be laid, and then the existing track needs to be taken up and new track laid.

The third video is a short segment north of Kennedy, showing that the new second track is now being used as the main track while the old track is starting to be removed. The turnout at the interim end of the double track just north of Kennedy has been installed.

It's certainly a lot of progress over the past few months, but I wonder just how long it will be before either section can be put in service. I would bet that the two segments won't be operable as double track before next spring. The station work may take much of next year.

- Paul

Last edited:

steveintoronto

Superstar
Member Bio
Joined
Mar 14, 2016
Messages
10,167
Reaction score
4,333
Speaking of Georgetown, what was the reason for moving the bus stop to the north parking lot from the loop on the south? Was it the improved accessibility for train-bus connections? The route adds a few minutes compared to the old south side loop, which was a quick shot to Downtown Georgetown and Guelph Street.
Initially, IIRC, it was the repaving of Queen Street forced a detour, and that was 'to the other side' of the tracks. Why it stayed there is a good question. It does make it handier to access from the north, but convoluted from the south.


Neutrino

Active Member
Member Bio
Joined
Dec 4, 2017
Messages
970
Reaction score
728
Dammit, from your video it seems like there were a few empty parking spots at Agincourt. I needed to get downtown for 1 p.m. Was going to take the 12:01 from Agincourt, but thought the lot would likely be full. Ended up missing the 12:08 from Kennedy because I couldn't find my way through the construction (brainfart).


Allandale25

Senior Member
Member Bio
Joined
Oct 19, 2007
Messages
3,421
Reaction score
2,465
I had business in Markham today, and while coming back I took some video of progress on the Stouffville line.

Most notable is that the hardware for a set of crossovers is staged around Progress Ave. That demarcates the North and Central zones of the project. Supposedly Milliken-Progress is to be put in service first, and Progress-Kennedy second. From my observation, there is a lot more to do north of Progress than south of it.

This first video starts at Milliken, heading southward. It shows that apart from some small bits north of McNicoll, the second track bed isn't anywhere near ready for laying track. Lots of water, some excavations still going on, and lots of fiber conduit that remains to be trenched, and much sound fencing to install. Plenty of progress on the tunnels at Agincourt (as there was at Milliken). One has to remember that after the second track is laid, it becomes the single main line while the "old" line is torn out and relaid with vibration matting and then fresh ballast and concrete ties. So really we aren't at the 50% track laid point yet.

The second video runs from Agincourt southwards. One can see that the bridgework over the creeks is just getting underway. Again, lots of second track needs to be laid, and then the existing track needs to be taken up and new track laid.

The third video is a short segment north of Kennedy, showing that the new second track is now being used as the main track while the old track is starting to be removed. The turnout at the interim end of the double track just north of Kennedy has been installed.

It's certainly a lot of progress over the past few months, but I wonder just how long it will be before either section can be put in service. I would bet that the two segments won't be operable as double track before next spring. The station work may take much of next year.

- Paul
Great video and observations, @crs1026


Tcmetro

New Member
Member Bio
Joined
May 14, 2009
Messages
12
Reaction score
0
I'm curious about the Confederation GO station. Is the rail station opening this year, or is it just the bus loop? What is the service plan once Confederation opens.

I've done some googling, but only yielded a few articles in the past year.


Platform 27

Active Member
Member Bio
Joined
Jun 24, 2009
Messages
756
Reaction score
29
Most notable is that the hardware for a set of crossovers is staged around Progress Ave. That demarcates the North and Central zones of the project. Supposedly Milliken-Progress is to be put in service first, and Progress-Kennedy second. From my observation, there is a lot more to do north of Progress than south of it.

This first video starts at Milliken, heading southward. It shows that apart from some small bits north of McNicoll, the second track bed isn't anywhere near ready for laying track. Lots of water, some excavations still going on, and lots of fiber conduit that remains to be trenched, and much sound fencing to install. Plenty of progress on the tunnels at Agincourt (as there was at Milliken). One has to remember that after the second track is laid, it becomes the single main line while the "old" line is torn out and relaid with vibration matting and then fresh ballast and concrete ties. So really we aren't at the 50% track laid point yet.
I was passing by on foot a few weekends ago and have a slight correction --- I think you have the sequence right, but the work is a bit further along.

They've already completed the process of putting in one finished "second" track to new standards for that Milliken-Agincourt section (with concrete ties, fresh ballast mats etc.), and your train is actually running on it ---- it's mostly on the east side of the corridor (the exception looks to be a little north and south of the McNicoll crossing where it's jogged over to west track's slot).

The old track, which had mostly been on the western side of the corridor, has now been ripped out and torn down to subgrade, where they'll repeat the same sequence to reconstruct to new standards, basically exactly what you described as the followup step.

You inspired me to dig up reaperexpress's video going the opposite direction over the same segment from last year to compare. As you can see, at that point the trains were running on the west side and most of the regrading was going on the east side.

So even through there are fewer visible cases of two parallel tracks next to each other, the north end is in fact more advanced than the south, and well past the 50% mark. That said, I don't see them actually using it right away, as it's not much good without at least that turnout at Progress and double platforms at Milliken and Agincourt.


crs1026

Senior Member
Member Bio
Joined
Oct 16, 2014
Messages
5,381
Reaction score
5,738
You inspired me to dig up reaperexpress's video going the opposite direction over the same segment from last year to compare. As you can see, at that point the trains were running on the west side and most of the regrading was going on the east side.

So even through there are fewer visible cases of two parallel tracks next to each other, the north end is in fact more advanced than the south, and well past the 50% mark. That said, I don't see them actually using it right away, as it's not much good without at least that turnout at Progress and double platforms at Milliken and Agincourt.
Quite true in plenty of places. I still wonder about the Finch to Havendale section....there isn’t enough room on the west side for the track to have been shifted, and with all the water and excavations there clearly hasn’t been a roadbed there ever....so I’m inferring that that section is still “original” track on the original alignment. Possibly the east side has been graded and that’s where the new track will go, so the west side doesn’t need much more than drainage and utilities, but the east track would still have to be put in service and the existing track torn out and rebuilt there.

....food for another trip. Hard to watch both sides at the same time!

I probably erred by implying that 50% of track is 50% of completion....that doesn’t give credit for all the work to do the retaining walls and grading beforehand, which is at least 50% of overall completion all by itself. Certainly, that kind of work seems to be pretty much wound up. All the same, there are only so many weeks left until winter, and there are lots of things remaining to be done.

- Paul


Platform 27

Active Member
Member Bio
Joined
Jun 24, 2009
Messages
756
Reaction score
29
Quite true in plenty of places. I still wonder about the Finch to Havendale section....there isn’t enough room on the west side for the track to have been shifted, and with all the water and excavations there clearly hasn’t been a roadbed there ever....so I’m inferring that that section is still “original” track on the original alignment. Possibly the east side has been graded and that’s where the new track will go, so the west side doesn’t need much more than drainage and utilities, but the east track would still have to be put in service and the existing track torn out and rebuilt there.

....food for another trip. Hard to watch both sides at the same time!
That's actually exactly the area where I was able to wander past on foot (geeky deviation after leaving a friend-of-a-friend's place around the corner) and all service is definitely running on concrete ties right up against the eastern sound barriers through there. It's certainly not spacious, but there's room for a track on the west side, and the level crossings have already all been twinned (visible in your video at Finch (2:35 mark), Huntingwood (3:10) and Havendale (3:30)). There evidently had to have been a track on that western half of the right of way until a short while ago, because it was in operation while they laid the eastern one. Regret not snapping any photos of my own.
