GO Expansion will still transform Greater Golden Horseshoe transit — but likely won’t be as ambitious as what was planned just three years ago
www.thetrillium.ca
OH WOW GO expansion is just DEAD like DEAD DEAD
Heres that scaleback that Reese probably saw at the conference awhile back
View attachment 657770
The number of trains per hour has been cut from 12 to eight, resulting in infrastructure changes, Molly Evans, Metrolinx’s vice-president of track specialized delivery, said in the November town hall.
Metrolinx leaders noted several other “de-scopes” in the town halls, including reductions in speed, cuts to the number and complexity of tracks, and abandoned platform upgrades.
Abandoning speed increases was a gut punch to one senior Metrolinx employee, who said travel time is the top reason people choose to drive, walk, bike or take transit.
“One of the biggest things that is going to really drive that modal share over to the rail network is travel time,” he said.

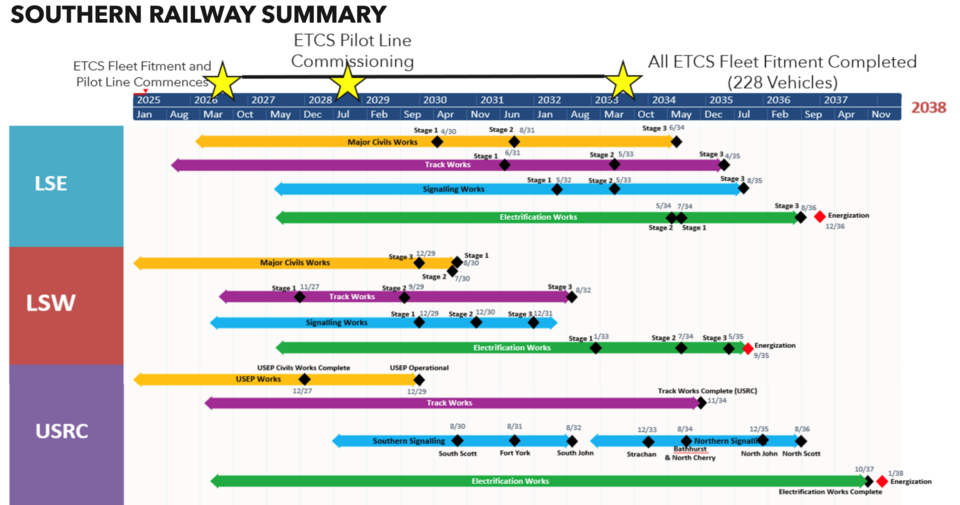

A high-level schedule presented to staff in April estimates that electrification will be complete in September 2035 for the Lakeshore West line, December 2036 for Lakeshore East, and January 2038 for the Union Station rail corridor.

But a December 2024 town hall only described electrification on the UP Express and Lakeshore lines. Under the minimum viable product, the agency plans to electrify from Burlington to Oshawa GO stations, with a gap at Union Station, Metrolinx consultant Shaun Kearney said in the town hall.
OH GOD THIS IS SO BAD USEP not done till 2029 AHAHAH
View attachment 657771
Shoutout to those who responded to the guy who asked for insider knowledge here from the trillium
