crs1026
Superstar

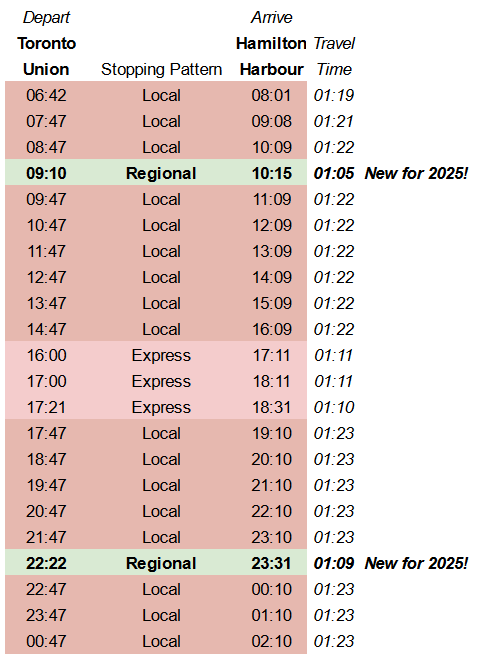

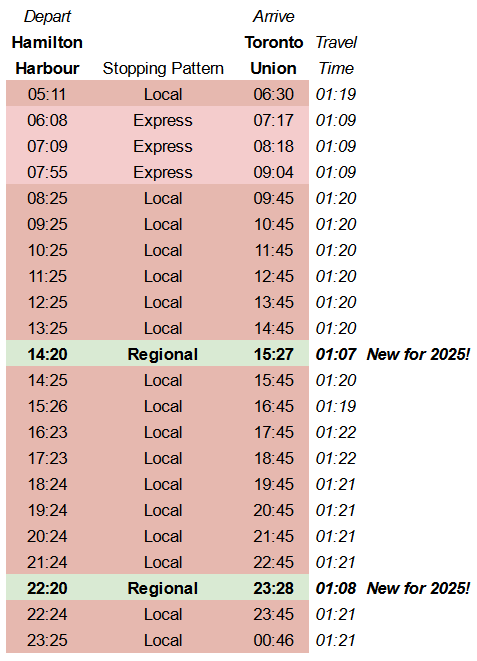

I hopefully will have to get Niagara Go Trains will start rolling into pocket track and cut down from 2h 24 minutes to 2h 4 mins by this month.
The signals cut in will likely take longer than that.
Consider this : When the two west facing dwarf signals are replaced by the three-light masts, the indications of the signals governing trains entering the station that lead to those new signals have to be reprogrammed and tested. And in turn, the indications of the approach signals to those entry signals also have to be redone....and possibly the block (or two) beyond that. Now count the number of different routings and thus permutations and combinations of signal indications into West Harbour from the Hamilton Jct area......it's actually a very complex junction and therefore a pretty large signals installation.
All eminently doable by a qualified signals design and field organization.... but it will take at least one significant outage in that territory, and then troubleshooting of any deficiencies... and then more testing. And the design paperwork may not even be ready as of today, so the field work may not even be happening yet.
- Paul
Last edited:
