hawc
Senior Member
Article mentions 18 years to refurbish whole fleet!
Not sure on where they got this information from, but according to this user, the Breslau passing track might go into service November 3rd. I have seen crews working on signals again recently, so at least signals may be up and running soon...
Service increases just from that section would be very limited if at all, but it could improve reliability (as I was stranded by a cancelled Kitchener train, the topic of that reddit post I got that info from.)
Real increases could be seen (with CN's cooperation) with the completion of Guelph Subdivision Construction Packages 2 and 4, which include the tie-in at Guelph, lay-by in Rockwood, and Acton passing track. I will note I have seen contractors doing surveying around that section of track in Guelph (Kent St). Other preliminary work before they could begin this package included the removal of an unused powerline around Rockwood.
Edit: Just to source the latest available dates. Note there is also a Package 3, which I'm not really sure where it specifically fits, it's encouraging to see a bunch of Kitchener Sub projects getting lined up, so work is incoming, so long as it's not pushed back again!
View attachment 607747
View attachment 607746
Not a might - that work is scheduled to be completed and the stretch of double track will be activated this coming weekend. Paperwork has already been distributed to all of the crews.Not sure on where they got this information from, but according to this user, the Breslau passing track might go into service November 3rd. I have seen crews working on signals again recently, so at least signals may be up and running soon...
We need softer lighting on the TTC subways. Always migraine inducingly bright.This is one promise Metrolinx has kept - ie to not repaint to the new scheme faster than required by refurbishment and wear and tear. When the new scheme was rolled out in 2014, ML stated that it would take 18 years to repaint the entire fleet.
GO train makeover will offer a plusher, greener commute
GO Transit’s trains and buses will slowly be refurbished with cushier ergonomic seats, softer lighting and a new green colour scheme.www.thestar.com
- Paul
I find the stations where they haven't installed the brighter lights, depressingly dingy.We need softer lighting on the TTC subways. Always migraine inducingly bright.
I don't like how East Harbour is so close to Union Station. Closer than Exhibition is to Union. The trains are going to move so slow between East Harbour and Union.

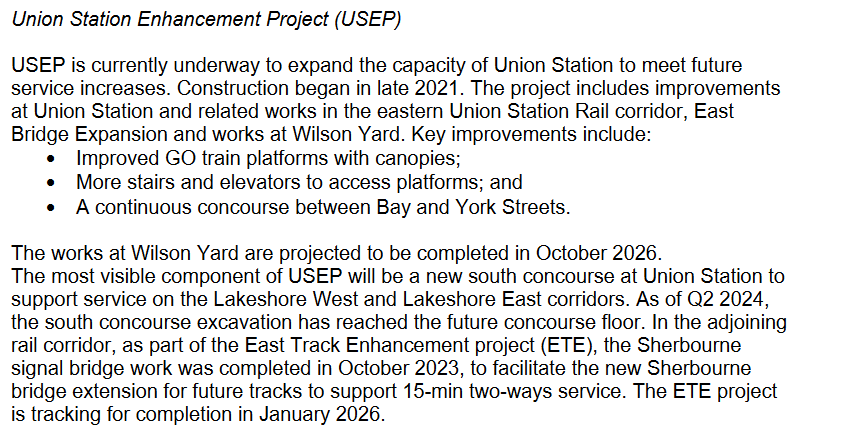

Aside from Electrification, is Metrolinx doing anything else to increase the speed of trains heading into and out of Union station? Signal and track improvements?
so theyve moved the goalposts to 2031!!... good god theyve become so incompetent....Many, many thanks to City of Toronto staff for giving us far more information about GO Expansion than Metrolinx does. And timelines (which are further away than ML has admitted, but at least COT is being up front)
There is also a very helpful listing of past decisions and reports, which is useful for those tracking how long this work is progressing
- Paul
Many, many thanks to City of Toronto staff for giving us far more information about GO Expansion than Metrolinx does. And timelines (which are further away than ML has admitted, but at least COT is being up front)
There is also a very helpful listing of past decisions and reports, which is useful for those tracking how long this work is taking and in some cases not progressing
- Paul
