GO Transit: Construction Projects (Metrolinx, various)

StealthyArrow

Active Member
Member Bio
Joined
Sep 21, 2020
Messages
211
Reaction score
801

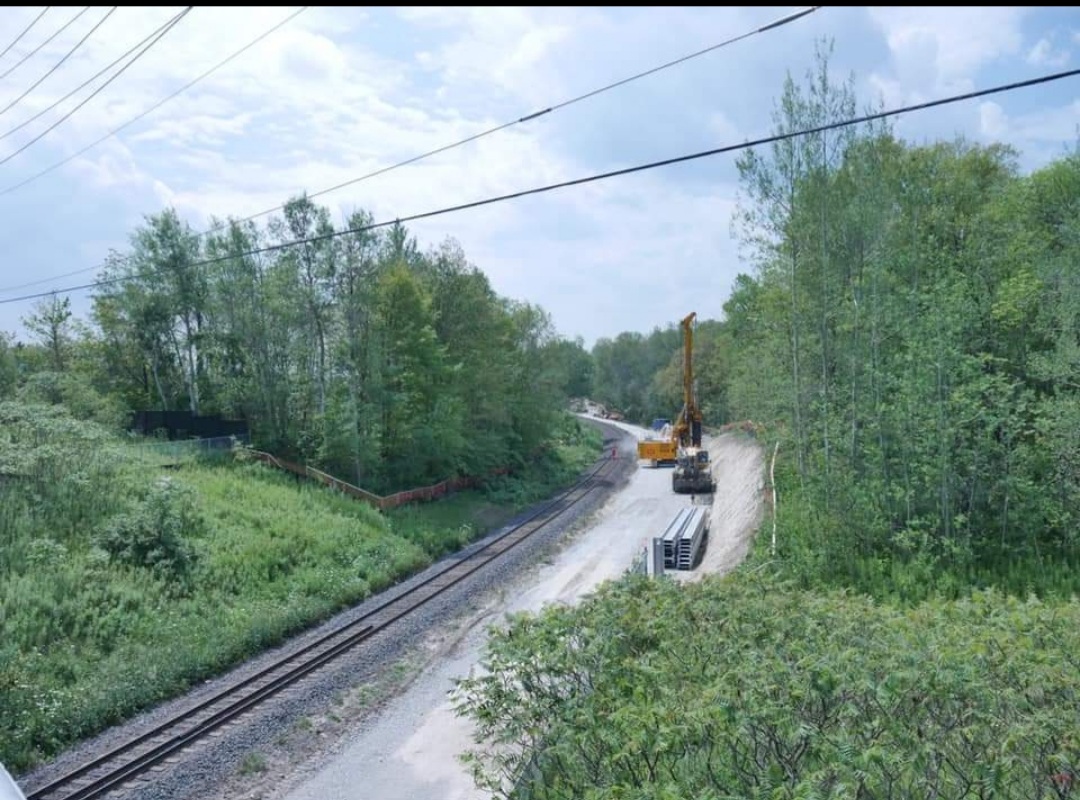

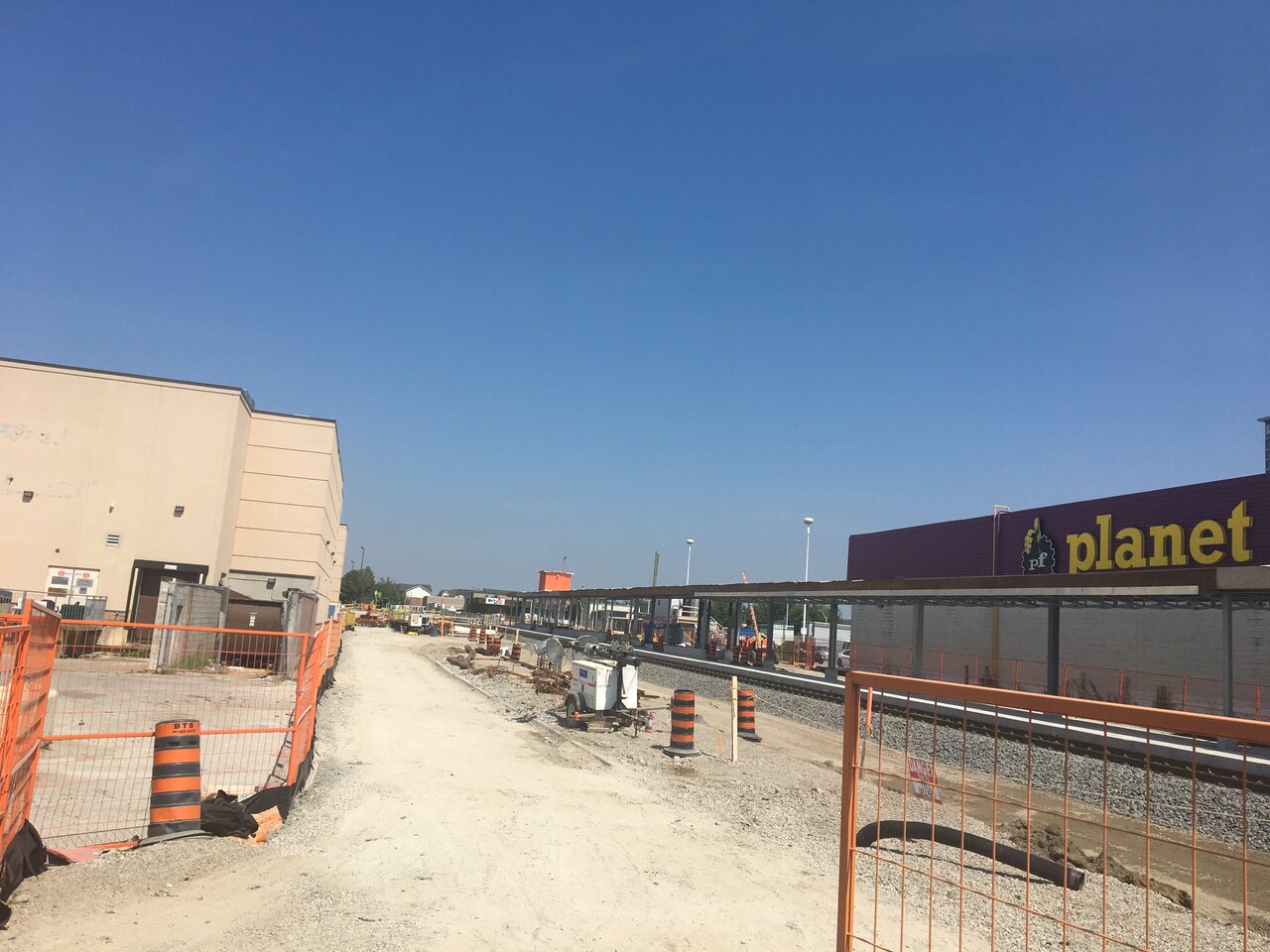

Milliken GO Station construction
7816f23a-9d01-4f35-b1d5-cfa67f008ef2-jpeg.339794

Meanwhile...

Attachments

  • 7816F23A-9D01-4F35-B1D5-CFA67F008EF2.jpeg
    187.4 KB · Views: 931
  • 1EF63F9D-DF63-428C-A3EC-704AAE17B956.jpeg
    342.9 KB · Views: 55
  • 1AC550E9-589B-4980-AF35-CD5E32AA2318.jpeg
    235.7 KB · Views: 55

smallspy

Senior Member
Member Bio
Joined
Nov 27, 2009
Messages
4,828
Reaction score
5,528
Before everyone gets their hopes up that the full double-tracking of the Barrie Line has started.....

Metrolinx has very quietly started work on another short section of double track on the Barrie Line. I don't have my notes handy, but I think that this will stretch from Mile 25 (just north of the Humber River crossing) to about Mile 27 (north of Bathurst).

Dan

crs1026

Senior Member
Member Bio
Joined
Oct 16, 2014
Messages
7,839
Reaction score
12,787
Before everyone gets their hopes up that the full double-tracking of the Barrie Line has started.....

Metrolinx has very quietly started work on another short section of double track on the Barrie Line. I don't have my notes handy, but I think that this will stretch from Mile 25 (just north of the Humber River crossing) to about Mile 27 (north of Bathurst).

Dan
Which just happens to be nearby the lumber yard that CN served during the day, causing bustitutions….I had heard that there was a plan to construct a runaround track, but things went quiet on that. I’m not sure if the lumber yard even receives loads any longer, may have switched to transload.

- Paul

reaperexpress

Senior Member
Member Bio
Joined
Nov 20, 2009
Messages
2,390
Reaction score
3,240
Location
the original Holland Marsh
Before everyone gets their hopes up that the full double-tracking of the Barrie Line has started.....

Metrolinx has very quietly started work on another short section of double track on the Barrie Line. I don't have my notes handy, but I think that this will stretch from Mile 25 (just north of the Humber River crossing) to about Mile 27 (north of Bathurst).

Dan
Here's my attempt at illustrating the new double track section under construction (in orange). I'm probably a bit off with the exact start/end locations.
Existing double-track segments in green

I wonder what they plan to do with it. My guess is that it has something to do with addressing the ridiculous train movements included in the weekend schedules due to the through trips to Allandale.

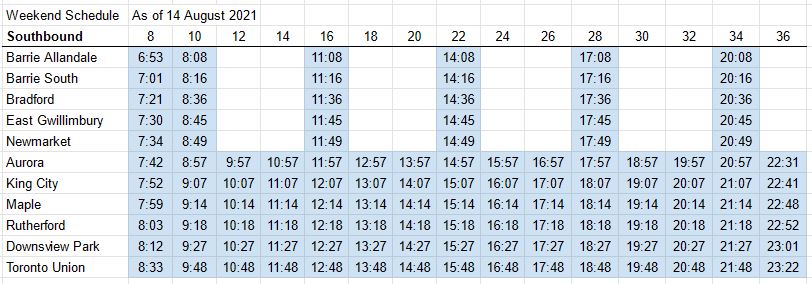

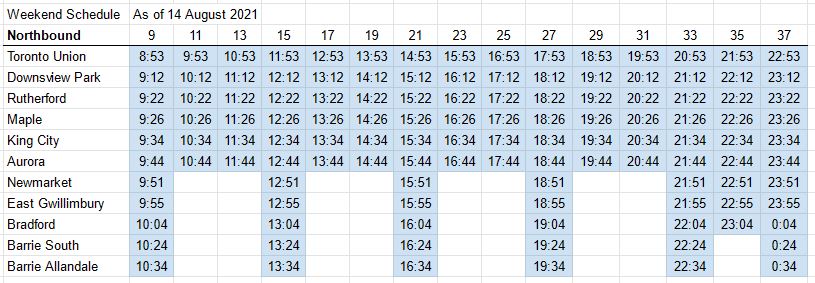

Normally the hourly pattern is that the northbound train arrives at Aurora at :44, then departs southbound at :57. But the train arriving at 11:44 doesn't depart southbound at 11:57, because that is already covered by run 16 arriving from Allandale. So that earlier train needs to go hide somewhere for an hour to let run 16 past, as well as run 15 which is heading north to Allandale. I assume that it gets stashed in the siding between Maple and King City. It then needs to follow run 15 up to Aurora, in order to start run 18 southbound at 12:57.

The simplest purpose for the new segment of double-track is to keep the same operation, but store the extra train closer to the station.

The more interesting notion is that the trains to Barrie would slot in between the hourly services, passing them at this new siding and another new siding exactly 30 minutes south of it (somewhere around Eglinton). That way the base hourly service could arrive and depart Aurora regularly rather than every third train needing to go sit a time out for an hour while the Allandale services pass by.

smallspy

Senior Member
Member Bio
Joined
Nov 27, 2009
Messages
4,828
Reaction score
5,528

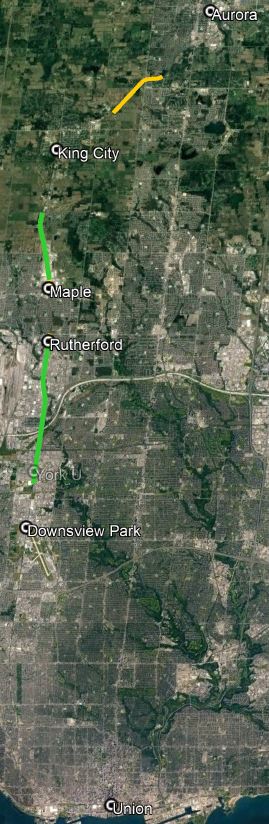

Here's my attempt at illustrating the new double track section under construction (in orange). I'm probably a bit off with the exact start/end locations.
Existing double-track segments in green
View attachment 340085

I wonder what they plan to do with it. My guess is that it has something to do with addressing the ridiculous train movements included in the weekend schedules due to the through trips to Allandale.

View attachment 340081
View attachment 340080
Normally the hourly pattern is that the northbound train arrives at Aurora at :44, then departs southbound at :57. But the train arriving at 11:44 doesn't depart southbound at 11:57, because that is already covered by run 16 arriving from Allandale. So that earlier train needs to go hide somewhere for an hour to let run 16 past, as well as run 15 which is heading north to Allandale. I assume that it gets stashed in the siding between Maple and King City. It then needs to follow run 15 up to Aurora, in order to start run 18 southbound at 12:57.

The simplest purpose for the new segment of double-track is to keep the same operation, but store the extra train closer to the station.

The more interesting notion is that the trains to Barrie would slot in between the hourly services, passing them at this new siding and another new siding exactly 30 minutes south of it (somewhere around Eglinton). That way the base hourly service could arrive and depart Aurora regularly rather than every third train needing to go sit a time out for an hour while the Allandale services pass by.
This is the thing.....no one knows what this one is for, at least in terms of my contacts within Metrolinx.

Maybe Paul has it right in that this will help prevent issues with CN servicing the lumber yard up there. It would certainly go a long way towards doing that. It would also give GO another place to have trains meet if one is running late - it could help prevent cascading delays further down the schedule.

Dan

Last edited:

EnviroTO

Senior Member
Member Bio
Joined
Apr 22, 2007
Messages
4,519
Reaction score
1,538
Location
Yonge & Mt.Pleasant
Milliken and Mount Dennis are going to have amazing visibility from the street. This kind of station design which leads to street views of passengers and trains coming into the station and easy access to both sides of the street (for Milliken) should be more common. It is convenient to pedestrians to have the station so well connected to the street and acts like a billboard advertising GO service.

At Mount Dennis there isn't a south side of Eglinton entrance but everything that a pedestrian would walk to on the south side would be reached via the Weston intersection, Black Creek intersection, or via Photography Drive anyways.

allengeorge

Senior Member
Member Bio
Joined
Jun 27, 2019
Messages
1,315
Reaction score
3,109
"late this year"
thats sooner than the march 2022 date ive heard about

My understanding is that the track work for the tunnel is on procurement, and they hope to have it finalized late this year. I think the full electrification contract is still sometime next year?

Coolstar

Senior Member
Member Bio
Joined
Mar 22, 2019
Messages
1,397
Reaction score
2,977
Location
Toronto
My understanding is that the track work for the tunnel is on procurement, and they hope to have it finalized late this year. I think the full electrification contract is still sometime next year?
No. I interpret it as:

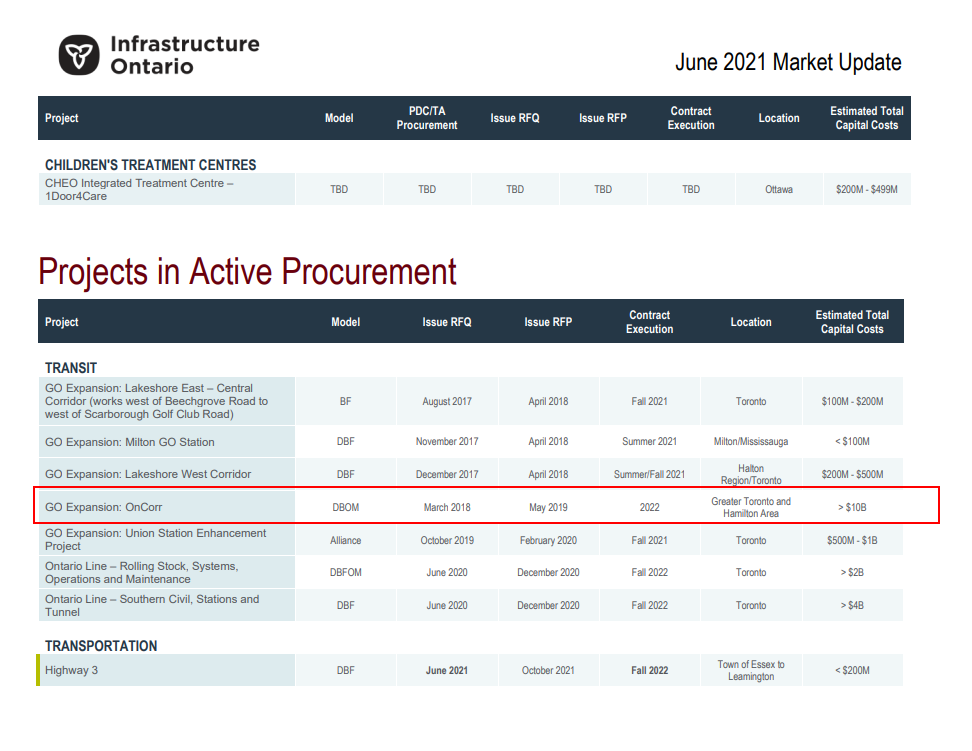

- The track laying at the 409/401 tunnel is part of the OnCorr works for GO Expansion.

- They announce the winning team for the OnCorr works late this year.

- Financial close happens in March 2022.

- OnCorr works start in late 2022/2023.

Allandale25

Senior Member
Member Bio
Joined
Oct 19, 2007
Messages
7,273
Reaction score
10,290
No. I interpret it as:

- The track laying at the 409/401 tunnel is part of the OnCorr works for GO Expansion.

- They announce the winning team for the OnCorr works late this year.

- Financial close happens in March 2022.

- OnCorr works start in late 2022/2023.

And the latest IO visualization of that in case any new members here haven't seen it.

Top
