Also ancillary space is always in demand - cleaning, storage, station staff offices - as well as retail units. Could make the station feel less cramped, too
I agree, but I think the more important take-away is that those spaces need to be somewhere.

In some cases - and honestly, historically, too - a lot of them were placed at track/platform or concourse levels, in what would have otherwise been wasted, unused space. But now that we have additional devices that need that space and the spaces below, and a need to keep those spaces still existing (albeit in a new location), we come to a situation where the easiest way out is to build at the surface.

Dan

Northern Light

Superstar
Member Bio
Joined
May 20, 2007
Messages
21,249
Reaction score
51,620
Location
Toronto/EY

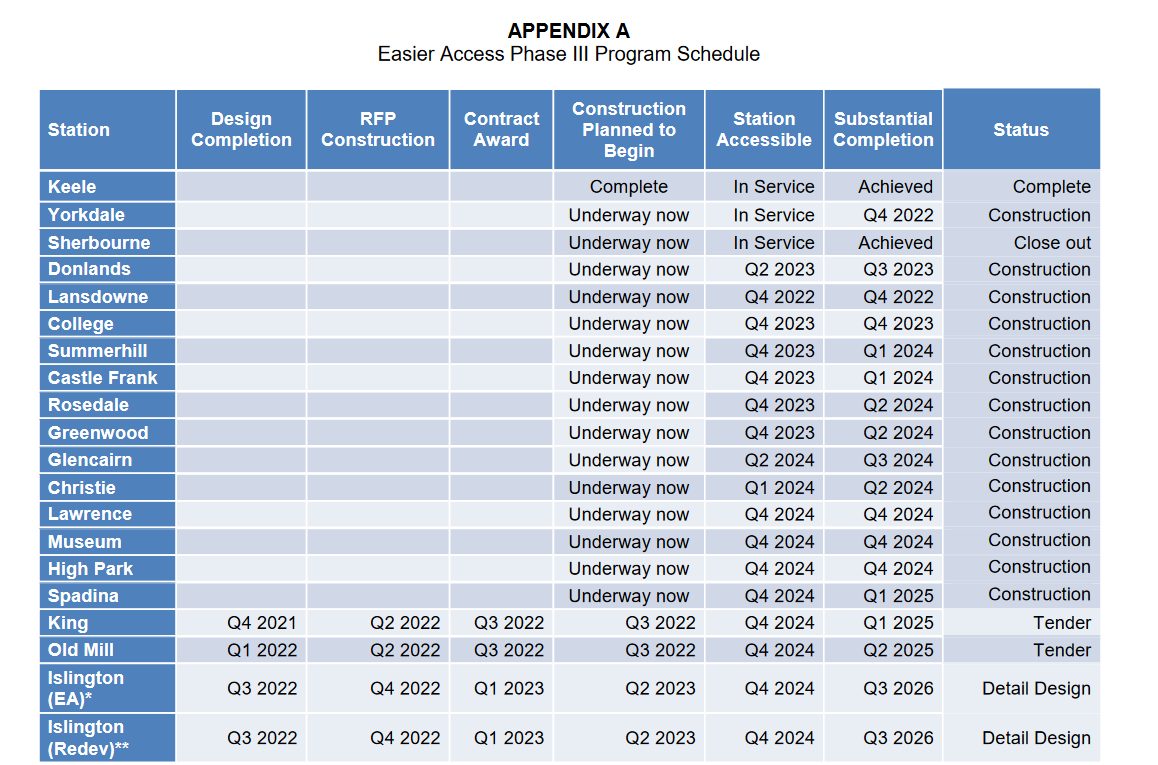

New tender out for the elevators at Old Mill:

Northern Light

Superstar
Member Bio
Joined
May 20, 2007
Messages
21,249
Reaction score
51,620
Location
Toronto/EY
We have a render for the Museum Station second exit.

Apparently it is going into Queen's Park after all:

Looking north towards the War Memorial

Construction to begin by Q3 2022 (so, imminently)

The new elevator is going out by the main entrances on Queen's Park Circle

****

Additional note, construction for the elevators at Christie Station is imminent (listed as, ' as soon as June 6th' )

Northern Light

Superstar
Member Bio
Joined
May 20, 2007
Messages
21,249
Reaction score
51,620
Location
Toronto/EY

Richard White

Senior Member
Member Bio
Joined
Dec 7, 2015
Messages
5,329
Reaction score
3,645
Location
Scarborough, Ontario

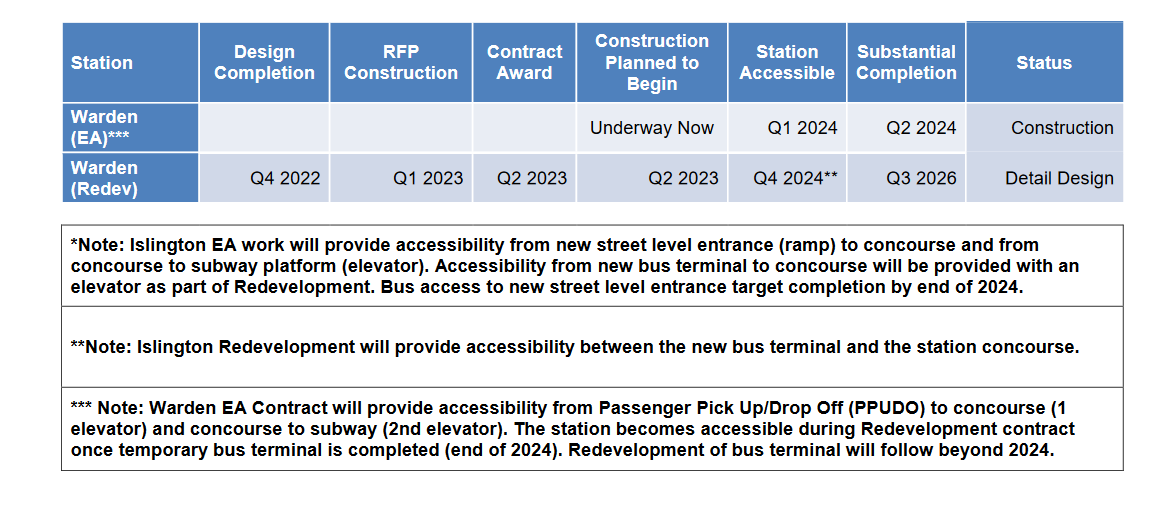

I do believe work is in the process of getting underway at Warden. There are 2 large white construction trailers in where the bus bay exit area is. One of the trailers arrived last week and the second came this week.

No actual work going on in or around the station but the trailers would not be there if work was not imminent.

Richard White

Senior Member
Member Bio
Joined
Dec 7, 2015
Messages
5,329
Reaction score
3,645
Location
Scarborough, Ontario

Northern Light

Superstar
Member Bio
Joined
May 20, 2007
Messages
21,249
Reaction score
51,620
Location
Toronto/EY
As per The Star, Construction on Museum Station's new elevators and second exit will begin tomorrow:

Of note, this will result in Queen's Park north of Hoskin getting lane reductions to 2SB lanes and 1 NB lane. ( a reduction of one NB lane)

Also, the project is apparently costing 26M. Man that's stiff for scope of this size.........
